These connection applications will be managed annually, through a bidding procedure, which will consist of three phases.
This page provides you with information on the capacity allocation procedure for connecting hydrogen production projects to the natural gas transmission and distribution network. This procedure is mandatory for all companies with a hydrogen production plant that wish to connect to the natural gas network.
Circular 2/2025 of the CNMC (National Commission for Markets and Competition in Spain) and the Resolution of 13 June 2025 set out a bidding process, structured in phases, to allocate available capacity in a transparent, orderly and objective manner.
This video describes the different phases of the process to determine the hydrogen injection capacity in the natural gas network.
These connection applications will be managed annually, through a bidding procedure, which will consist of three phases.
*The dates provided are indicative and may be subject to change depending on the circumstances outlined in the Resolution of 13 June 2025, as well as the application of non-working days under Circular 2/2025.
The developers must send preliminary information to the Gas System Technical Manager, Enagás GTS, which will determine the conditional connection capacity available for each area, in coordination with the operators, within 15 working days from 1 October of each gas year.

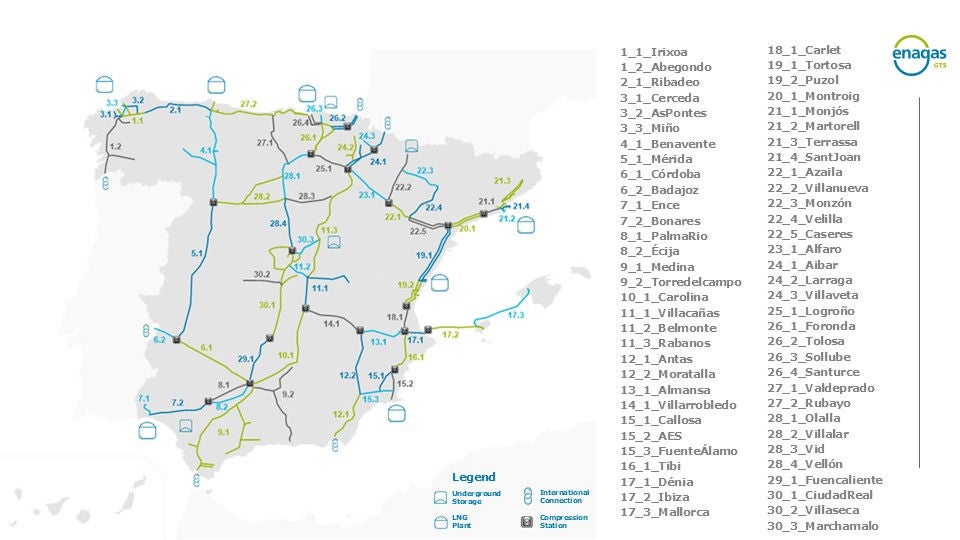

In order to analyse the conditional connection capacity of hydrogen production plants in the Gas System, Enagás GTS has segmented the network into areas. Each area groups together the distribution and secondary transmission grids connected to them, so that the conditional capacity calculated per area corresponds to the maximum injection capacity available that is aggregated over the positions of both the transmission grid and the interconnected secondary transmission and distribution grids. Check these areas on the following map:
In order to continue with the application process for the allocation of hydrogen connection capacity to the natural gas network, developers must fill in the form corresponding to the network it wish to connect to from 1st to 21st October 2025.
Capacity determination
Operators shall communicate the final results of their analysis to the applicant companies upon completion of the assessment and verification process. Enagás GTS will publish the final allocated capacity on this page.
Frequently asked questions about capacity allocation for hydrogen projects
